Graph Coloring
Problem 1

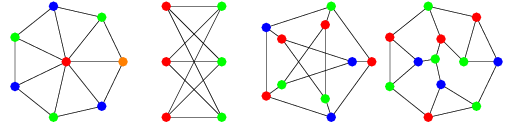

For these problems, the following graphs are given as examples

Part A
A graph is said to be two-colorable if it is possible to label the
vertices with one of two colors so that no adjacent vertices have the same
color. For example, the second graph above is two-colorable whereas the others are not two-colorable.
Write the psuedocode for a function IsTwoColorable that returns true if a given graph is two-colorable,
and returns false otherwise. Assume that the graph given is connected,
i.e., there is a path between every pair of vertices.
Part B
Given your solution to Part A, describe how you would need to modify it to determine if the given graph was three-colorable. A graph is three-colorable if it is possible to label the vertices with any of three colors such that no adjacent vertices have the same color. Note, any graph that is two-colorable is three-colorable.
Problem 2
The data given below shows the steps necessary in the planning of a construction job. You should draw a graph that represents the dependencies between the various tasks and then attempt to answer the questions below.
Building a House (Cost of materials not in model) # WaitOn Task Name hrs Labor Cost 1 Clear & Excavate 16 4000.00 2 1 Foundation & Masonry 40 6400.00 3 2 Framing & sub-floors 32 3840.00 4 3 Sheathing 24 2880.00 5 3 Roofing 24 4320.00 6 4 5 Windows & Doors 20 2800.00 7 6 Siding 24 2880.00 8 7 Exterior Paint 20 2400.00 9 3 Rough Plumbing 24 4800.00 10 6 Rough Electric 36 7200.00 11 6 Rough HVAC 40 8000.00 12 9 10 11 Drywall 40 4800.00 13 12 Attic Insulation 12 1440.00 14 12 Hardwood Flooring 16 2560.00 15 12 Finish Carpentry 40 6400.00 16 12 Paint & Wallpaper 48 6720.00 17 19 Carpets 16 1920.00 18 16 Finish Electric 22 4400.00 19 12 Finish Plumbing 26 5200.00 20 12 Finish HVAC 28 5600.00 21 12 Kitchen Carpentry 40 7200.00 22 21 Appliances 6 960.00 23 8 13 14 15 Punch List 24 4800.00 17 18 19 20 / 21 22 / 101520.00
For each of the problems below, give an algorithm for how to determine the answer. Then use the data above to test your algorithm.
- If everything goes according to plan, how long will it take?
- If we could cut the time in half by increasing the labor costs30%, where would that make sense?
- Would it be worth it if the cost of not being done was $1000 per day?
- Identify the critical path.
